Skip to main content

Gantt View

Overview​

Gantt view is a different view of tasks/bugs in eTask. Gantt view served for the following purposes:

  • Giving an overview of milestone of the project.
  • Quick glance on status of tasks/bugs within day/week/month/year.

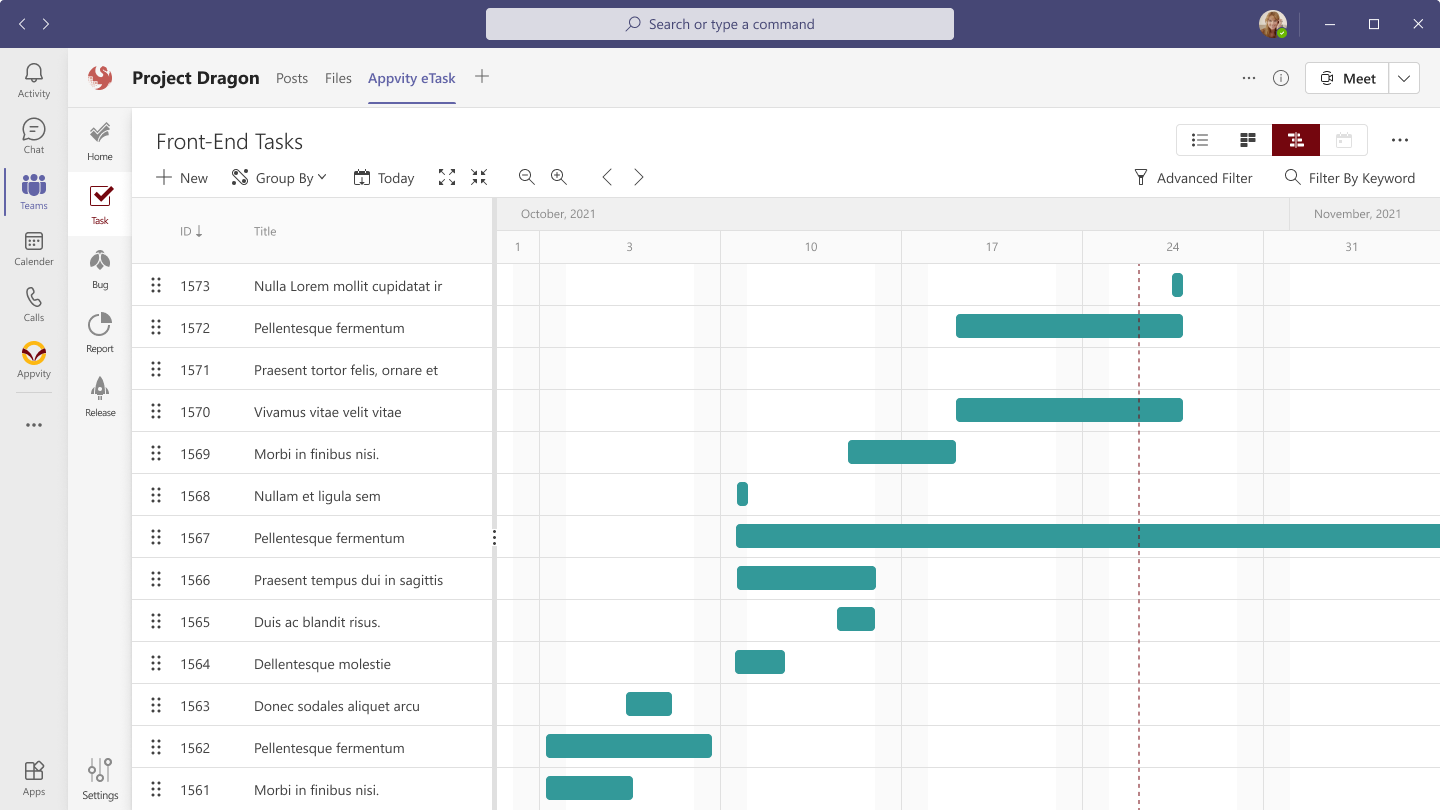

eTask Task List View

  • There are 3 main components:
    • Tool Bar.
    • Task List.
    • Gantt Display.

Tool Bar​

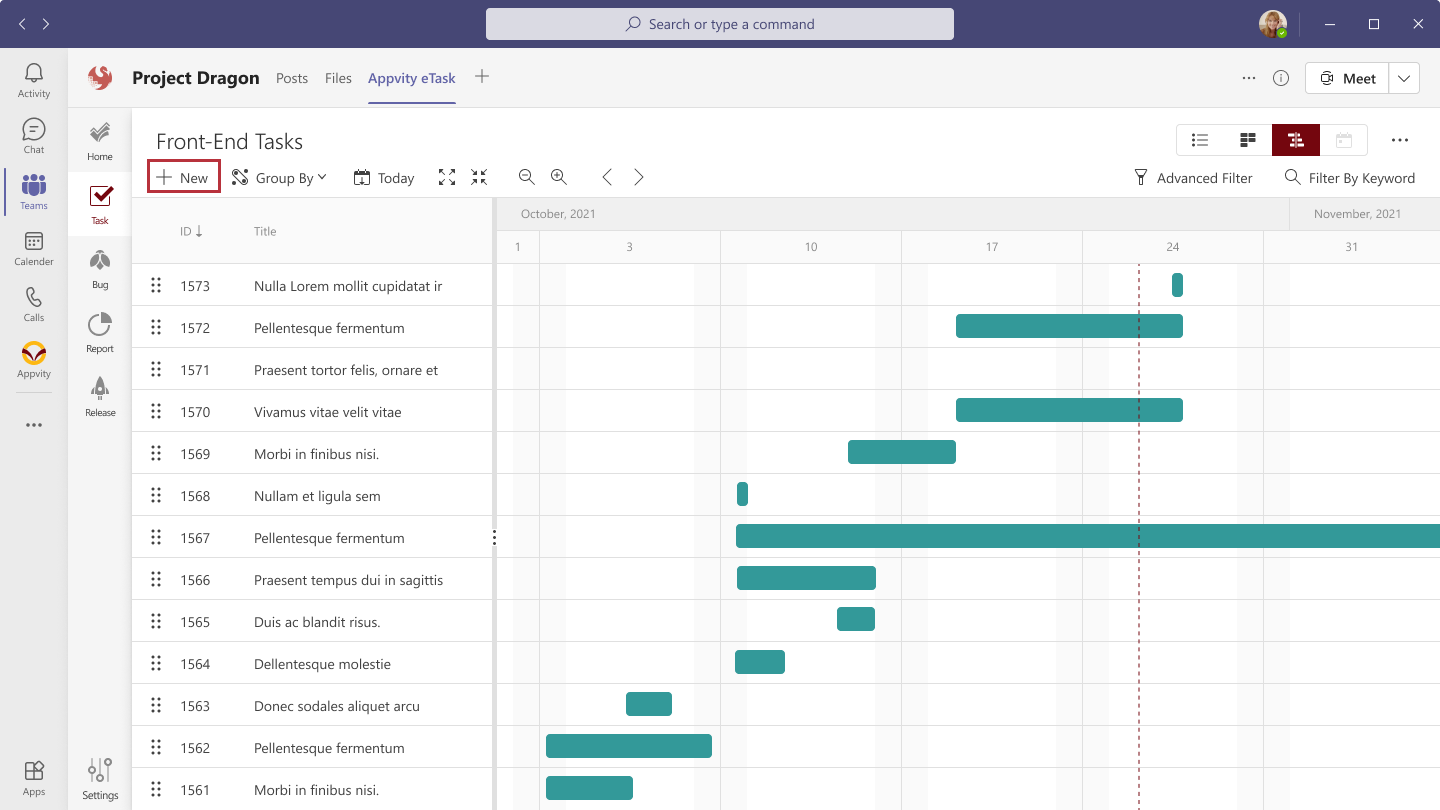

eTask Task List View

  • Create task – Open the task form.

eTask Task List View

  • Expand all.
  • Collapse all.
  • Zoom level: the zoom level is adjustable; user can see the Gantt in 5 fixed timespane:
    • Year | Quarter | Month (by default) | Week | Day.
  • Refresh: Refresh the Data of Gantt view.
  • Previous: Get to previous timespan (depends on Zoom level).
  • Next: Get to next timespan (depends on Zoom level).
  • Today: Slide to current system date time.
  • View Types:
    • Project View:
      • Showing parent-child relationship of all tasks.
      • The Start Date and Due Date of the Parent | Child belongs to the Child | Grand child will be starting from smallest Start Date to highest Due Date within the tasks in the group.
    • Resource View:

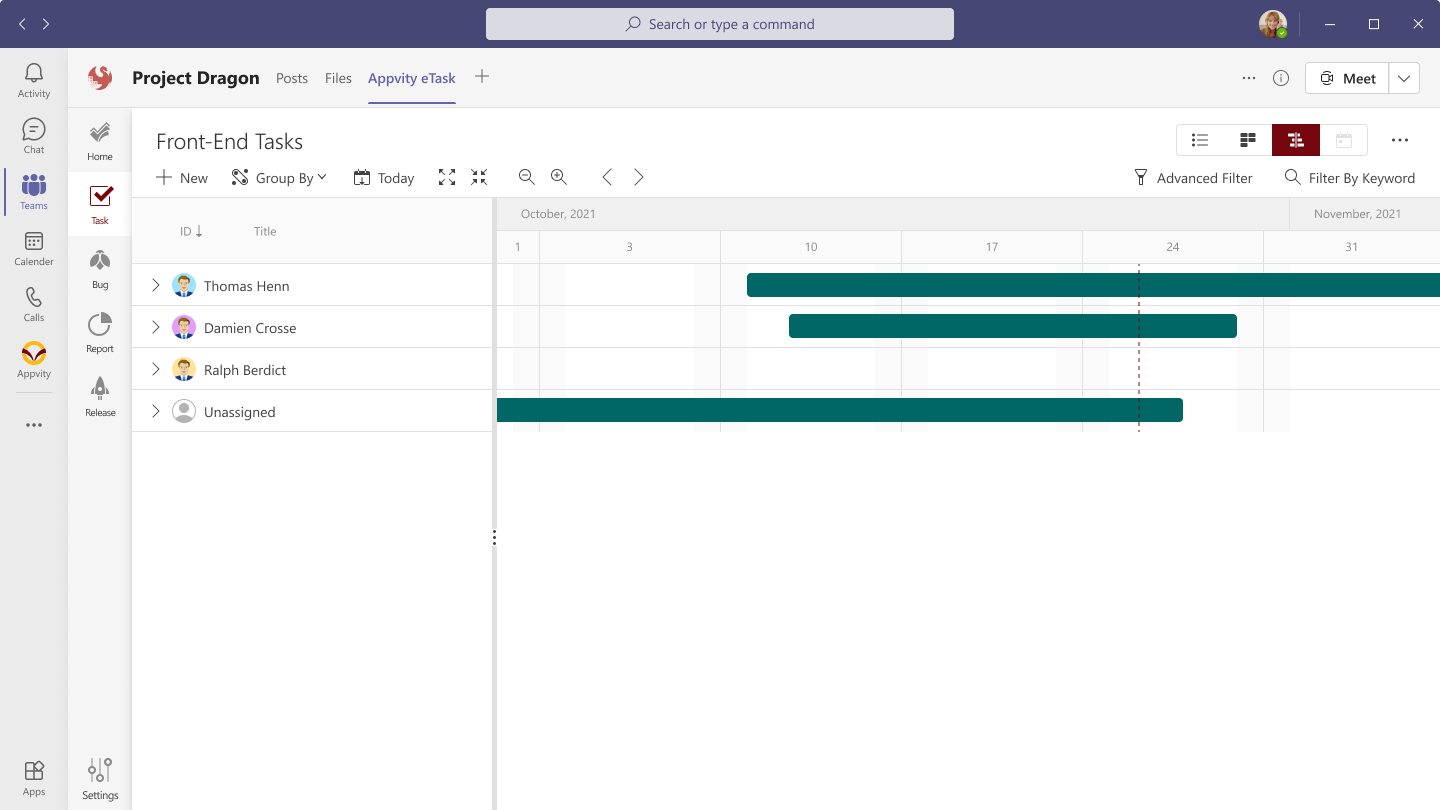

      • Showing all tasks grouped by “Assigned To”.
      • If the task has a Child and the same Assigned To as the Child’s Assigned To, then it will show the parent-child relationship; else the Child will be shown as 1st level in another Assigned To group.
      • Each “Assigned To” will have Start Date, Duration, Due Date value. The value is depending on the Tasks existed with the appropriate Zoom timespane.
      • If a task is assigned to multiple users, then it will be shown in multiple places.
      • Drag and Drop task in Task List to another group will change “Assigned To” property.
  • For example, dragging “Task 4” to Cloud User 3 > if the dragged task is from Cloud User 1 then the task will be re-assigned from Cloud User 1 to Cloud User 3.
  • Task 4 will have 2 assignees: Cloud User 2 and Cloud User 3. eTask Task List View - Phase View: - Showing all tasks grouped by “Phase”. - Each “Phase” will have Start Date, Duration, Due Date, and Completion (Later) value. The line for Phase will depend on the Phase Duration (when create Phase) in Settings. - If the tasks within Phase exceed the Start-Due date, then it will prolong the line of those tasks but not the Phase line. - Drag and Drop task in Task List to another group will change “Phase” property. - If the task has a Child and the same Phase as the Child’s Phase, then it will show the parent-child relationship; else the Child will be shown as 1st level in another Phase group. - For example: Task A (Phase 1) has Children Task A.1 (Phase 1) and Task A.2 (Phase 2) - Task A and Task A.1 has the same Phase 1 will be displayed as Parent-child. - Task A.2 is a Child of Task A but has the different Phase so it will be shown in Phase 2. - Note: “Create Sub-task” or “Drag & Drop” does apply for 3 levels as usual. - Story View: - Showing all tasks grouped by “Story”. - If the task has a Child and the same Story as the Child’s Story, then it will show the parent-child relationship; else the Child will be shown as 1st level in another Story group. (preferred to Phase View) - Each “Story” will have Start Date, Duration, Due Date, and Completion (Later) value. The value is depending on the Tasks existed with the appropriate Zoom timespane. - Drag and Drop task in Task List to another group will change “Story” property.

Task List​

eTask Task List View

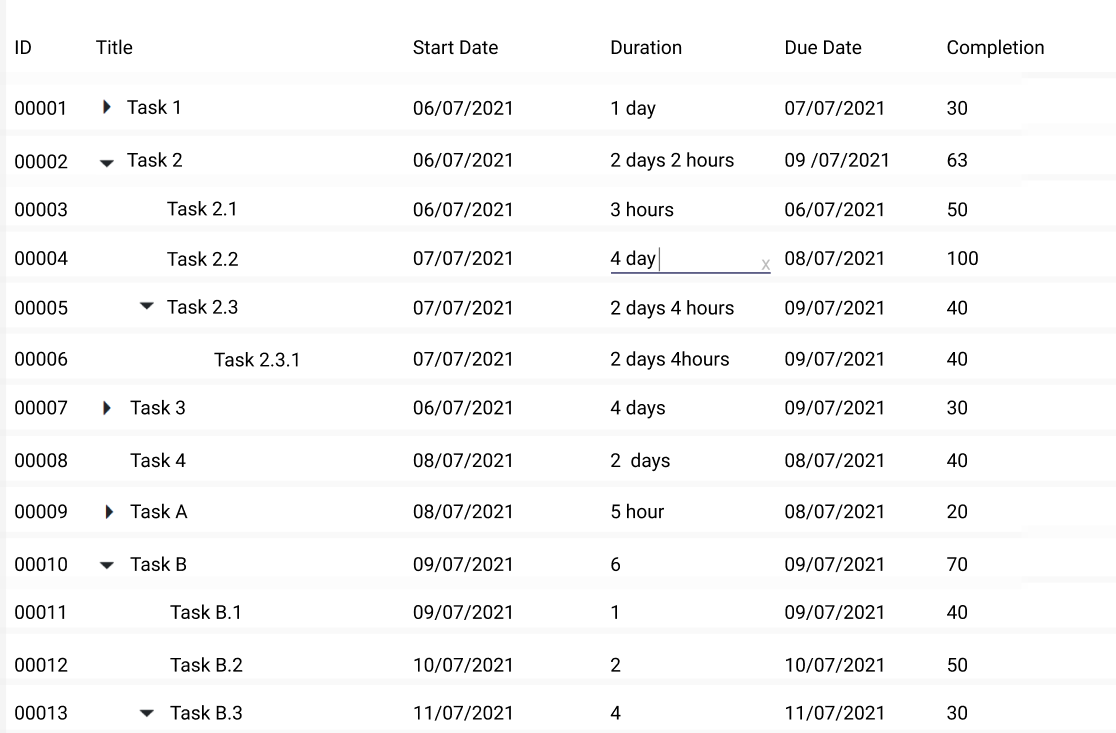

  • Task list shows all the tasks of channel. Tasks without Start/Due Date or Duration will not be shown in Gantt Display.
  • The task list display columns:
    • Default.
      • Task ID (always show).
      • Title.
    • Optional (can be set in Settings).
      • Start Date (including Date picker and Time picker).
      • Duration.
      • Due Date (including Date picker and Time picker).
      • Assigned To.
      • Completion.
    • Tasks can add sub-tasks on multiple levels (future – for now, we only support 3 levels Parent > Child > Grand Child).
      • The Start Date and Due Date of the Parent | Child belongs to the Child | Grand child will be starting from smallest Start Date to highest Due Date within the tasks in the group.
  • Clicked on the task to show Gantt View on the right.
  • Expand All | Collapse all to show/hide all the relationship.

Task List - Context Menu​

  • Hover on a Task to show “Context menu”:
    • Edit: Open edit task form.
    • Create sub: Create task under that task – If the hovered task is Grand child, there is no “Create sub” button.
      • The Create/Edit task form should be in pop-up type which can keep the zoom, expand/collapse when opening or closing the form.
      • The sub-task will have the same information as the parent:
        • Source.
        • Phase.
        • Story.
        • Start Date (user can change this later – if Start Date extend longer than the parent, then it will change the parent’s Start Date when saved).
        • Due Date (user can change this later – if Due Date extend longer than the parent, then it will change the parent’s Due Date when saved). eTask Gantt View
      • After creating a sub-task, the Parent task cannot be edited for Start-Due Date and Duration field.
    • Clone: Clone a task with exact information of that task. If the selected task has children, then the clone task will not generate the children.
    • Get link: Copy link.
    • Indent.
      • Indent: Applied for task with Parent | Child only. If the task tree has Grand Child, then it cannot be indented anymore.
    • Outdent.
      • Outdent: Applied for task has Parent only (Child and Grand Child task). When clicked on Indent, the task will have the same level as Parent.
    • Delete: Delete task.
      • If the deleted task is a Parent, the Child tasks will remove the parent-child relationship.

Task List - Drag & Drop​

  • Drop a task to re-schedule the Start Date of that task at the Dropped position, and keeping the Duration fixed to calculate the Due Date accordingly.
  • Task List allows drag and drop task row to change parent-child relationship.

eTask Task List View

eTask Task List View

  • Allow to Drag & Drop with the limit of 3 levels:

    • Move the task to the upper/lower position on the different level:
      • if the task tree of the dragged task has 3 level, then it cannot be dropped under any task. It can only drop to the first level.
      • If the task tree has 1 or 2 level, then it will depend on the dropped level. Must not exceed 3 level of task.
      • If the task tree plus dropped level exceeded 3 level, then the task cannot be dropped Under position of the dropped level.
  • Does not allow to Drop will show mouse cursor:

    • Unavailable eTask Task List View

Task List - Edit Inline​

  • Double click on a cell to edit the selected fields. These fields are allowed to edit: eTask Task List View - Title. - Start Date. - Duration. - Due Date. - Completion. - Note: The Duration and Due Date is related, if there is a change in either one of them, the other will change accordingly.

Gantt View​

The Gantt view will display the relationship of tasks in timeline view including:

  • Parent task.
  • Child task.
  • Milestone.
  • Timeline.

eTask Task List View

  • The color of Parent | Child task can be set up in Gantt Settings.
  • The Gantt will gray out the dates excluding in Work Week.
  • For Day display, the Gantt will gray out the time excluding in Working Time.
  • Task display in Gantt:
    • If the task does not have Start Date – Do not show in Gantt Display.
    • If the task only has Start Date – Do not show in Gantt Display.
    • Note: for tasks without Start-Due date, let SyncFusion decide for now.
    • If the task has Start Date and Due Date/ Duration then it will be shown in Gantt Display.

Gantt View - Drag & Drop​

If a task is created or “Drag & Drop” out-of-scope of Business Hours, that task will take the next available day in Business Hours.

eTask Task List View

  • For example, Business Hour is from Monday to Friday and then dropping a task on Saturday or Sunday, that task will set Start Date is on Monday, and Duration is still the same to calculate the Due Date.

Gantt View - Line Card​

eTask Task List View

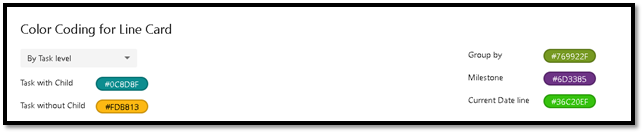

  • User can setup Color Coding for properties:
    • Status (including red for Overdue).
    • Priority.
    • Custom Fields (single choice).
      • If the selected is a Custom Field choice, then user delete or disabled that Custom Field, the value will be reset to “Status”.
  • Or setup on level:
    • Parent Tasks.
    • Child Tasks.

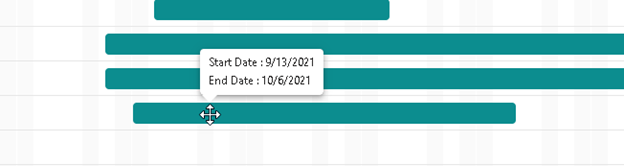

Gantt View - Hover Card​

  • Hover on a task line to show detail of that task.

    eTask Task List View

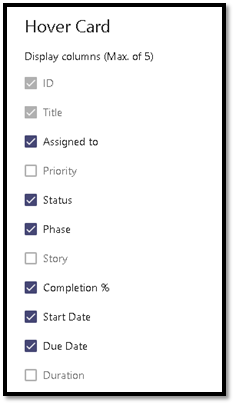

  • User can setup in Settings which properties will be shown on Hover Card.

    eTask Task List View

Note: please refer to configuration for Gantt.
